Home Page

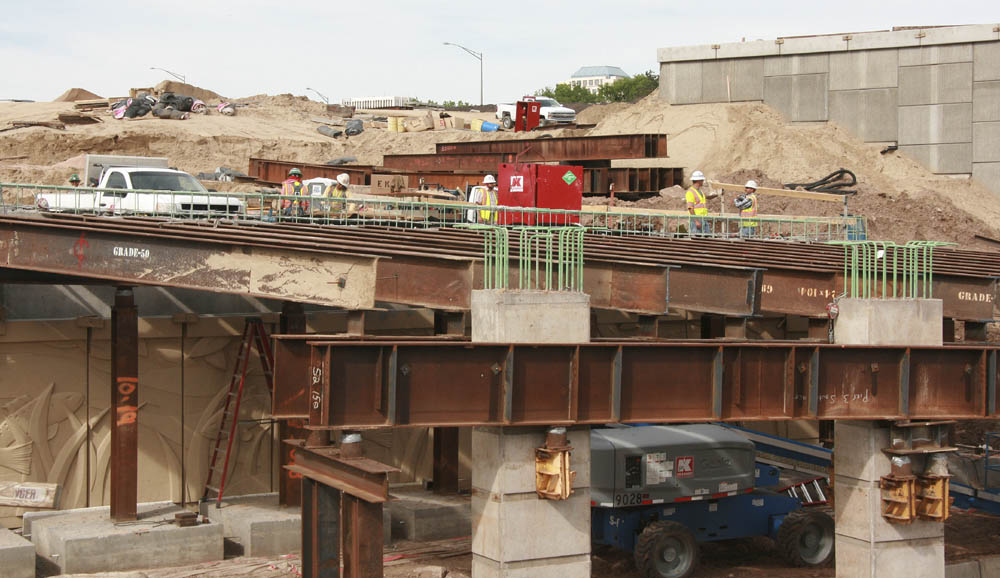

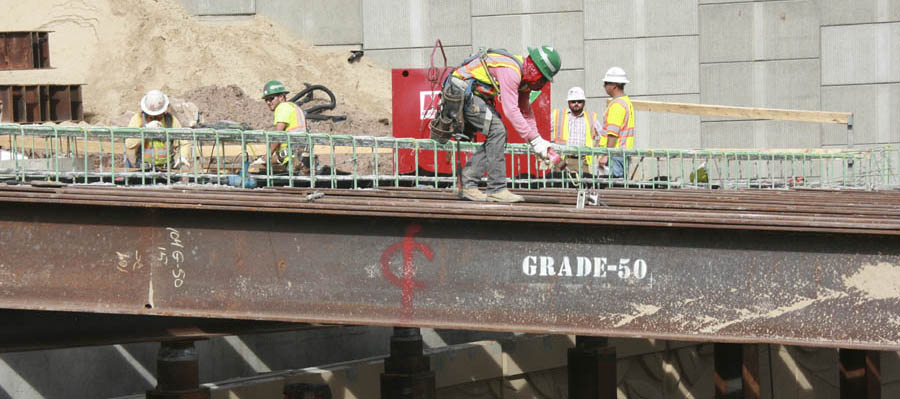

A crew with the contractor, Kraemer/TSH, works on the new, permanent bridge for the southbound off-ramp at the Cimarron/I-25 interchange.
Westside Pioneer photo

New bridge over Fountain Creek milestone in continuing Cimarron project

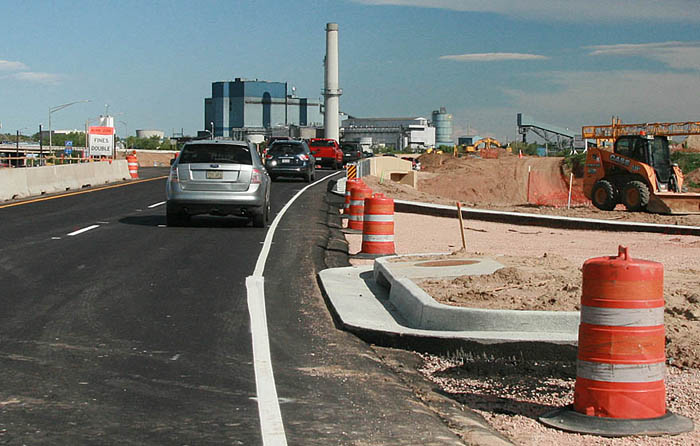

Eastbound traffic moves over the just-opened bridge over Fountain Creek. The curb cuts at right are for access from Cimarron Street (Highway 24) to the future shortcut (aka "quadrant") to alleviate traffic at the Cimarron/Eighth Street intersection.
Westside Pioneer photo
UPDATE, June 17: The "split-lane" configuration described in paragraphs 4 and 5 below is scheduled to be in place Sunday, June 19 at 8 a.m., after an overnight closure of southbound I-25 between the Cimarron and Tejon interchanges.

       Drivers on Cimarron Street are getting their first taste (albeit a small one) of what it will be like when the project at the I-25 interchange is finished.

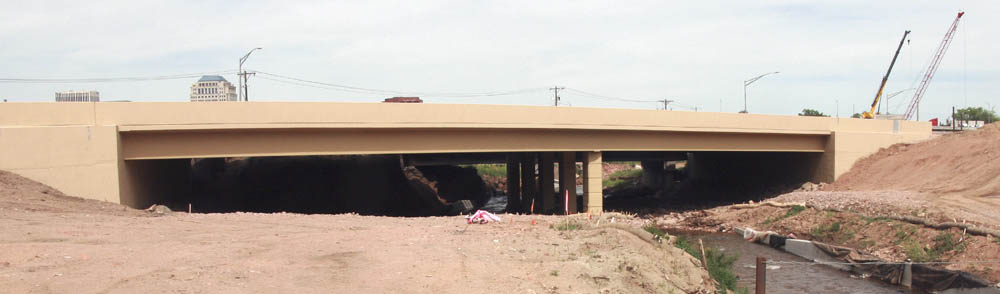

       It's the eastbound portion of the new bridge over Fountain Creek. Eastbound traffic, which for months had swerved in a slight detour around the bridge construction area, was redirected June 4 onto the new, straighter, roughly 500-foot alignment after one last overnight project that tied the pavement into the existing roadway.
       In coming months, the new bridge will be expanded, width-wise, to make room for westbound traffic, which is still using an older bridge north of the new one, explained Don Garcia of Wilson and Company, a project consultant to the Colorado Department of Transportation (CDOT). “It's like pieces in a puzzle,” he commented.
       Other work over the June 3-4 weekend moved northbound traffic lanes slightly to the east between the Tejon and Cimarron interchanges. Garcia described this as preliminary to a temporary move later in June in which southbound vehicles will start using two lanes that are normally on the northbound side.
       This “split-lane” configuration (as it's being called) will allow interstate work just to the west of it “for several months to level out lane elevations and prepare for the final alignment of I-25,” a CDOT press release states.
       The contractor is Kraemer/TSH. The $113 million interchange replacement project started a year ago and is scheduled for completion in late 2017.
Hidden amid the continuing construction - in this case, the permanent bridge over Fountain Creek for the southbound off-ramp - are the completed fish-pattern concrete walls that will line the Midland Trail when it is eventually built into its new alignment along the north side of the creek as part of the Cimarron interchange project. The designs were selected for aesthetic enhancement after public input over a year ago.
Westside Pioneer photo

       Garcia said that no traffic problems have resulted from last weekend's changes. The now-straighter line on eastbound Cimarron (from the bridge opening described above) seems to be helping its flow, he added.
       The June 3-4 work was a milestone among numerous interchange construction activities in the area of Cimarron/I-25 that will be continuing in the coming months.

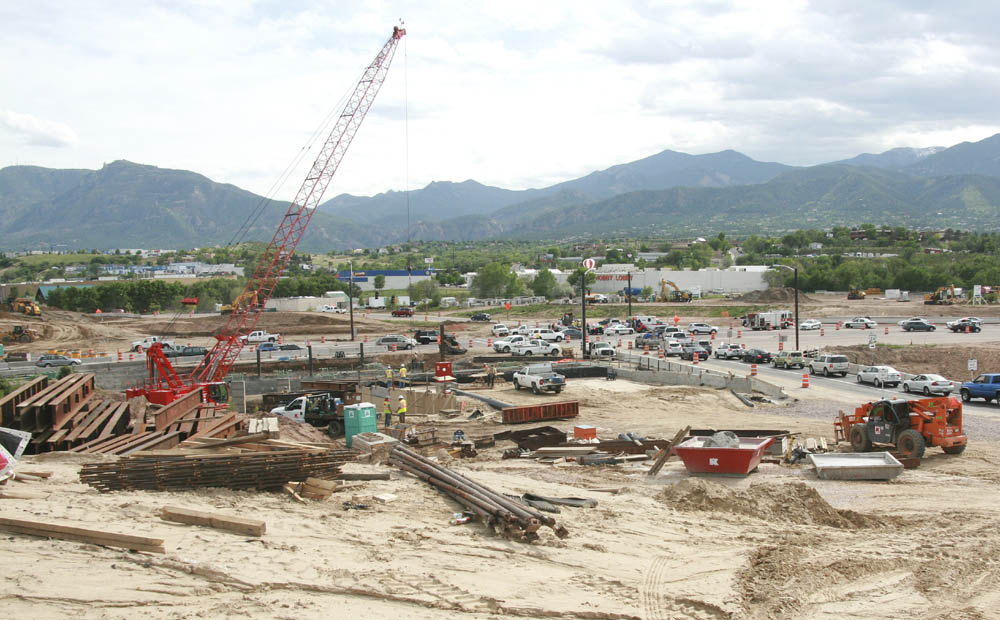

       Highly visible aspects at the interchange include the development of a new interstate bridge, about 75 feet west of the current one (chiefly to handle the southbound lanes), and the final southbound off-ramp (next to the recently opened temporary one), which will include a permanent bridge over Fountain Creek.
       In the area southwest of the interchange, on land that CDOT owns over to Eighth Street, a temporary batch plant is providing concrete for new road surfaces in the project zone, and work is getting started to naturalize Fountain Creek east of Eighth Street. The work will include widening the creek with a “low-flow”

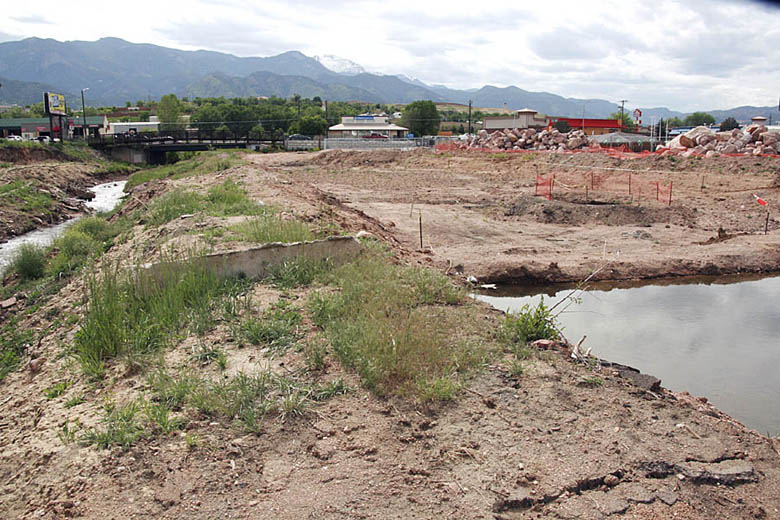

In a view from the state-owned open area southwest of the interchange (looking west), Fountain Creek flows under its bridge at Eighth Street. On the right (partly seen) is a temporary detention pond. As part of the project, the creek will be widened into a more natural state, 80 feet wide with a 15-foot-wide low-flow channel; also, underground measures will be taken to prevent contamination from a recently discovered, long-closed landfill from reaching the creek, according to the Colorado Department of Transportation.
Westside Pioneer photo
channel down the middle to match the flood-controlling style between 8th and 21st.
       An unexpected addition to the project scope - an $800,000 expense that CDOT is absorbing, according to Garcia - involves containment of seepage from a long-forgotten landfill north of the creek. CDOT does not know when the dumping occurred there, but he said it certainly pre-dated the hotel (demolished shortly before the interchange project) that had been built on the site in the 1960s.
       Garcia added that the extra work required for the containment is part of the reason why the “shortcut” between Cimarron and the Eighth - intended to provide relief to that intersection - has been delayed until 2017. The road, conceived by the Kraemer/TSH team (which calls it the “quadrant”), will eventually connect to Cimarron west of the interchange and to Eighth Street south of the Acorn station, where a stoplight will line up with the currently difficult access to the Colorado Place shopping center.
       Overall, Kraemer has termed the current construction activities “Phase 1.” The work from May 2015 to May of this year was called “Phase 0.” Phase 1 is to continue “through late winter 2016,” the press release states.
       The release also provides a month-by-month list (which appears below), identified as “activities to expect in summer 2016.” Exact dates for closures are weather-dependent and not yet determined. (Note: The list has been edited for clarity.)
JUNE:
       · A full overnight closure of southbound I-25 between the Tejon and

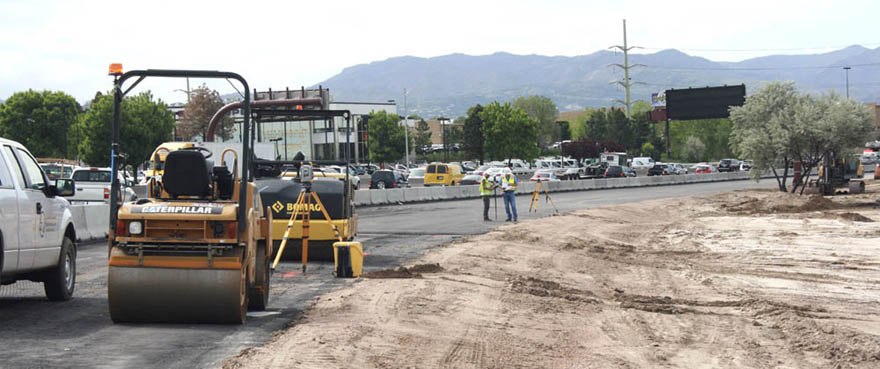

In work the afternoon of June 3, two workers stand on recently poured shoulder pavement on northbound I-25 in preparation for a traffic change that weekend. The change has since moved the northbound lanes slightly to the east (making use of the shoulder) on a temporary basis for about half a mile between the Tejon and Cimarron interchanges. Guardrails have also been installed at the pavement's edge along much of this section.
Westside Pioneer photo
Cimarron interchanges to install traffic controls and restripe and move barriers.
       · Overnight lane restrictions on westbound Highway 24 to switch traffic onto new pavement.
       · Lane restrictions on southbound I-25 for paving operations.
JULY:
       · Full overnight closures of Highway 24 at the Cimarron interchange to set I-25 Phase 1 girders.
       · Full overnight closures on Cimarron Street between Sierra Madre and Highway 24 to set girders for the widened Cimarron bridge over Fountain Creek.
       · Lane restrictions on Highway 24 for shift to permanent lane configuration west of I-25.
AUGUST:
       · Full overnight closure of I-25 southbound off-ramp for permanent alignment across permanent bridge.
THROUGH THE SUMMER:
       · Various overnight lane restrictions and traffic realignments on I-25 and Cimarron Street/US 24 to allow for removals, restriping and paving activities; to set barriers; and for bridge construction.
       · Eastbound Cimarron Street between I-25 and Sierra Madre St. will continue to be reduced to one lane.
       · Westbound Cimarron Street between I-25 and Sierra Madre St. will continue to be reduced to two lanes.
       On the interstate, traffic in the daytime will be maintained at three lanes each direction, according to CDOT. Speeds are limited to 55 mph.

Westside Pioneer article
(Posted 6/7/16, updated 6/17/16; Transportation:Cimarron/I-25)

In a view from a contractor work area just west of the interstate, traffic can be seen backed up on the temporary southbound off-ramp to Cimarron Street. Meanwhile, just east of there, construction continues for the permanent ramp. When it eventually replaces the temporary version, the temp's bridge will be reused in a similar manner for work on the northbound on-ramp, which will also span Fountain Creek.
Westside Pioneer photo
The new Cimarron Street (Highway 24) bridge over Fountain Creek is seen from state-owned property southwest of it. Planned creek improvements will result in a broader creek channel, spreading out to encompass either side of the center abutments.
